Project management for agencies: the operating system
A practical guide to project management for agencies: the cadence, templates, and meeting-capture habit that stop scope creep from eating your margin.
Updated June 12, 2026
Project management for agencies is not the same job as project management inside a product company, and treating it like one is why so many agencies run at thin margin. A product team manages one roadmap with one set of stakeholders. An agency manages a dozen clients at once, each with its own scope, its own approver, and its own habit of changing the brief on a call you did not write down. So here is the thesis: at an agency, the project plan is not the artifact that protects your margin. The accurate record of every client conversation is. Build your project management around capturing decisions and scope changes the moment they happen, and the board, the timeline, and the invoice all stay honest.
Why agency project management is different
Three things make agency work structurally harder than internal project management, and your system has to answer all three.
You serve many masters at once. A product PM optimizes one backlog. You are running parallel projects for clients who do not coordinate with each other, do not see each other's deadlines, and each believe they are your only account. Your system has to keep context separated cleanly so a status on Tuesday for one client does not bleed into the wrong project.
Scope is the product, and it leaks. Your deliverable is defined by a statement of work, and every casual "could you also..." on a call is a scope change whether you logged it or not. The Project Management Institute's research has long pegged scope creep as a problem on roughly half of all projects. For agencies the bill is specific and measurable.
The decision record lives in meetings, not in the tool. This is the part that gets undersold. Approvals, revision requests, change orders, and "yes, ship it" almost always happen out loud on a kickoff, a review, or a weekly check-in. Your project tool tracks the task that results from that decision. It never saw the decision. That gap is where agencies lose money and lose arguments.
Read those numbers together. More than half of agencies are bleeding four figures a month on work they did, and the large majority almost never bill for it. The reason is rarely that the agency does not want the money. It is that they cannot prove the out-of-scope request happened, because it happened on a call and the only record is somebody's memory. Capture fixes the proof problem.
The agency project management operating system
You do not need a heavier tool. You need a repeatable loop that runs on every account. Here it is end to end.
- 1
Scope it in writing
Every project starts with a statement of work that names deliverables, the approver, the revision count, and what is explicitly out of scope. This is your reference point for every later dispute.
- 2
Run the kickoff and capture it
Hold a structured kickoff, and record the conversation. Decisions and assumptions made here become the project's source of truth, not someone's notes.
- 3
Turn decisions into tracked work
Pull action items, owners, and dates out of the meeting and into your board (Asana, ClickUp, monday, or a PSA tool). Every task traces back to a moment in a call.
- 4
Run a weekly status with the same cadence
Same day, same format, same agenda for every account. Capture it too, so the status is a record and not a vibe.
- 5
Catch scope changes the instant they happen
When a client asks for something out of scope on a call, the recording is your evidence. Flag it, quote it, and bill it before it disappears into 'just doing them a favor.'
- 6
Close with a written recap
Send a recap after every client meeting so decisions are confirmed in writing within hours, not relitigated in a month.
The loop is boring on purpose. The point of agency project management is not creativity in the process; it is sameness in the process so your brain is free for the creative work the client is actually paying for. Below is each step with the specifics.
Step 1: Scope it so disputes have an answer
The statement of work is your contract with reality. The agencies that almost never bill for out-of-scope work are usually the ones whose SOW is too vague to point at. A usable SOW names four things explicitly:
- Deliverables, listed and countable. Not "a website" but "5 page templates, 1 blog template, 2 rounds of revisions per template."
- The approver. One named person who can say yes. If three people can request changes but only one can approve, write that down.
- Revision count, because "revisions" without a number is infinite revisions.
- Out of scope, stated plainly. The single most useful sentence in any SOW is the one that begins "This project does not include..."
If you are building the SOW from a sales conversation, our guides on how to create a proposal and the project kickoff agenda cover the handoff. The key habit: the SOW should be specific enough that when a client asks for a fifth revision, you can paste one line back and the conversation is over.
Step 2: The kickoff, captured
The kickoff sets every assumption the project runs on, which is exactly why you should not trust it to memory. Record it. Here is a kickoff agenda that works for client services, copy and adapt it.
CLIENT KICKOFF AGENDA (45-60 min)
1. Introductions and roles (5 min)
- Who approves? Who reviews? Who is day-to-day contact?
2. Goals and definition of done (10 min)
- What does success look like in the client's words?
- What is the one metric or outcome that matters most?
3. Scope walkthrough (15 min)
- Read the deliverables list out loud, confirm each one.
- Confirm revision count and what is out of scope.
4. Timeline and dependencies (10 min)
- Milestones, client review windows, blackout dates.
- What does the agency need from the client, and by when?
5. Communication plan (5 min)
- Weekly status day/time, channel, escalation path.
6. Risks and assumptions (5 min)
- Anything that could move the date or the budget.
7. Recap and next steps (5 min)
- Restate decisions out loud before ending the call.
Notice step 7. Restating decisions out loud at the end means your recording, and therefore your recap, captures the agreement cleanly. For the broader version of running this meeting well, see agenda for a project kickoff meeting and the top objectives for a first client meeting.
Step 3: Capture without a bot in the client's call

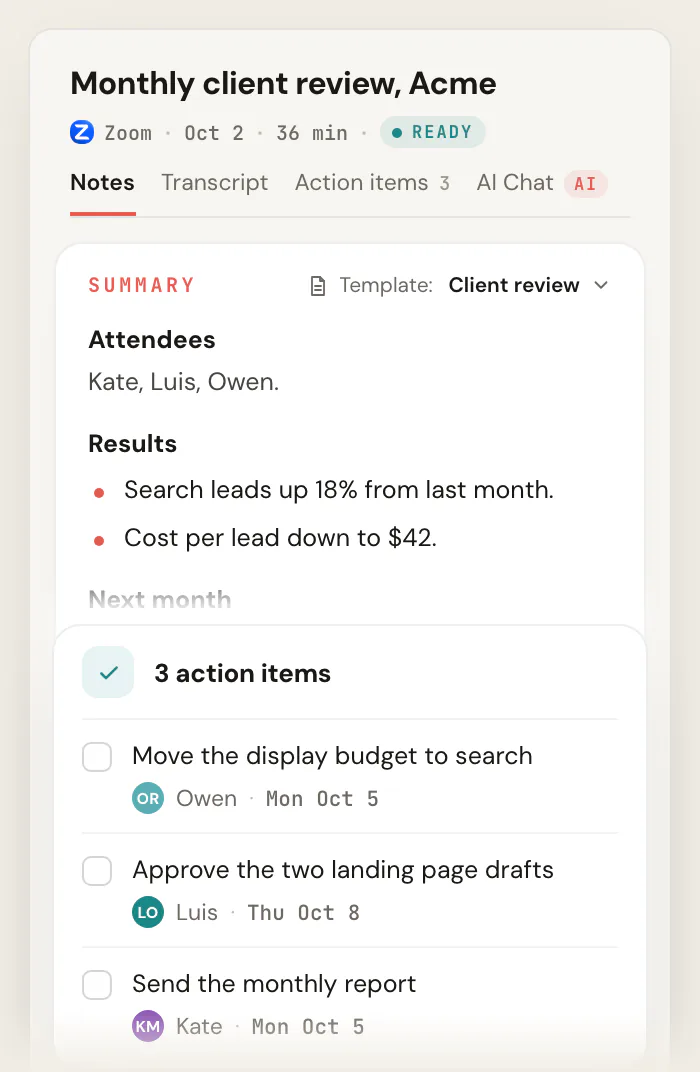

This is the operational heart of the whole system, so be deliberate about how you capture. Most AI notetakers built into project tools are meeting bots: they dial into the call as a visible, labeled participant the host has to admit. On an internal standup that is fine. On a client call it is friction you do not control. The client sees a stranger named "[Vendor] Notetaker" in their meeting, and plenty of enterprise clients disable external bots outright, so the bot silently never joins and you capture nothing.
For agencies that is the worst possible failure mode, because the meetings you most need on record (client reviews, change-order conversations) are exactly the external calls where a bot gets blocked. The fix is to capture from the browser, with nothing joining the call. That is what Scribbl does on Google Meet: it records, transcribes, and summarizes from a Chrome extension, so the participant list shows the actual people and the client never sees a robot. Zoom and Microsoft Teams are covered on the Team plan.
In this call
- You (account lead) host
- Client (approver)
- Client (stakeholder)
- Scribbl notes browser, not a participant
There is a strategy choice here worth naming. For internal team standups, a bot-based notetaker or a native Google Meet / Zoom recording is perfectly fine; nobody is going to be uncomfortable. Save the no-bot, no-friction capture for client-facing calls where the optics and the blocking risk are real. More on the mechanics in how a Google Meet AI note-taker works and the broader AI for agencies overview.
Step 4: Turn the recording into tracked work
A recording that sits in a folder is not project management. The job is to move decisions and action items out of the meeting and into the board, fast, while context is fresh. The pattern:
- After the call, open the meeting summary and pull the action items, each with an owner and a date.
- Drop them into your board as tasks, tagged to the right client and project.
- For any scope change, create a flagged item that links back to the moment in the transcript, so the evidence and the task live together.
This is where your project tool choice finally matters, and the right choice depends on how you bill. If you bill fixed-fee and track time elsewhere, a delivery board (Asana, ClickUp, Basecamp) is enough. If you bill hourly or on retainer and want utilization and invoicing in the same place, a PSA tool (Productive, Scoro, Teamwork's upper tiers, Workamajig for larger creative shops) earns its higher price. We compare them in detail in best agency project management tools and creative agency management software, so this guide stays focused on the process.
- Answers: what is the status and who owns what
- Great for tasks, timelines, and capacity
- Shows the work that resulted from a decision
- Blind spot: it never saw the conversation
- Cannot prove a client requested something out of scope
- Answers: what was actually decided and agreed
- Great for approvals, scope changes, and disputes
- Captures the decision before it becomes a task
- Blind spot: it is not a status tracker
- This is the evidence that lets you bill out-of-scope work
For keeping the board honest once items land, see action item tracking and how to manage multiple projects.
Step 5: A weekly status cadence that runs itself
The reason status meetings drift is that every account runs them differently, so they take prep every time. Standardize the format once and reuse it across all clients. The same recurring weekly check-in, same agenda, same recap. Capture it like the kickoff, so the status becomes a record of commitments rather than a conversation that evaporates.
WEEKLY CLIENT STATUS (15-30 min)
1. Last week: what shipped, what slipped, why.
2. This week: what is in flight and who owns it.
3. Decisions needed from you (the client) this week.
4. Risks to the date or the budget.
5. Any new requests -> confirm in/out of scope on the call.
Line 5 is the margin protector. When a new request surfaces in the status, you name it as in or out of scope right there, on the recording, instead of quietly absorbing it. For the rhythm of running these well, see meeting management best practices and how to manage client expectations.
Step 6: Close every client meeting with a written recap
Decisions confirmed in writing within hours of the call almost never get relitigated a month later. A recap is short and it does three jobs: it states the decisions, lists the action items with owners and dates, and flags anything that changed scope. Because you captured the call, the recap practically writes itself from the summary. A simple structure:
SUBJECT: Recap + next steps, [Client] [Project] [Date]
Decisions made today
- [Decision], approved by [Name]
Action items
- [Owner] -> [Task] by [Date]
Scope note (if any)
- [Request] is outside the current SOW. We will send a
change order to add it, or it stays out. Your call.
Next check-in: [Day/Time]
Templates for the surrounding communication live in the ultimate guide to after-meeting emails to clients, client meeting notes template, and meeting recap format.
The pitfalls that quietly drain agency margin
A few mistakes show up over and over. Name them so you can avoid them.
- Managing each client a different way. Bespoke cadence per account feels client-friendly and is operationally expensive. Standardize the loop; customize the deliverable, not the process.
- Trusting memory for scope changes. "I'm sure we can bill that later" is how 78% of agencies end up rarely billing out-of-scope work. If it is not on a recording or in writing, it did not happen for billing purposes.
- Letting a bot get blocked on the calls that matter most. Client reviews are where scope changes, and client meetings are where bots get blocked. Capture those without a bot.
- Treating the board as the source of truth. The board tracks tasks. The meeting record holds decisions. When they disagree, the recording wins, which is why you keep it.
- Skipping the recap. A decision that is not confirmed in writing the same day is a decision that gets re-argued. The recap is cheap insurance.
For the specific scope-creep playbook, see how to prevent scope creep. For running delivery across a portfolio, the project managers page lays out how this fits a client-services role.
Frequently asked questions
What is the difference between agency project management and regular project management?
Regular project management usually means running one roadmap for one organization with a coordinated set of stakeholders. Agency project management means running many parallel client projects at once, each with its own scope, approver, and budget, where the deliverable itself (scope) is the thing most likely to change. The biggest practical difference is that an agency's decision record lives in client meetings, so capturing those conversations accurately matters far more than it does internally.
How do agencies stop scope creep?
Three habits, in order. First, write a statement of work specific enough to point at, including a plain "out of scope" section and a revision count. Second, capture every client call so an out-of-scope request is on the record the instant it happens. Third, name new requests as in or out of scope on the call itself, and send a same-day recap that states it in writing. The research is blunt about the stakes: a large majority of agencies rarely bill for out-of-scope work, and the usual reason is they cannot prove the request happened. Capture solves the proof problem.
Do I need a PSA tool or just a project management board?
It depends on how you bill. If you bill fixed-fee or track time and invoicing in a separate system, a delivery board like Asana, ClickUp, or Basecamp is enough. If you bill hourly or on retainer and want utilization, profitability, and invoicing in the same place, a PSA tool such as Productive, Scoro, Teamwork's upper tiers, or Workamajig (for larger creative shops) earns its higher price and seat minimums. We break down the options in best agency project management tools.
Will an AI notetaker show up in my client's meeting?
If it is a bot-based notetaker (which most built-in PM notetakers are), yes: it joins as a visible labeled participant the host has to admit, and on Zoom the host's settings have to allow external bots. On client calls that is friction you do not control, and enterprise clients often block it. The alternative is browser-based capture that puts nothing in the participant list, which is how Scribbl records Google Meet for individuals free, with Zoom and Microsoft Teams on the Team plan.
How often should agencies meet with clients?
For most active projects, one standing weekly status (15 to 30 minutes) plus a structured kickoff at the start and reviews at milestones is the right baseline. The exact cadence matters less than its sameness: run the same format, same day, same agenda across every account so prep is near zero and the meeting becomes a reliable record instead of an ad-hoc check-in. Always close with a written recap so decisions are confirmed the same day.
