How to prevent scope creep: a change-control playbook
Scope creep is a missing-systems problem, not a willpower one. Here are the three artifacts that stop unpaid, unapproved work before it starts.
Updated June 12, 2026
Scope creep is not a discipline problem, and you do not fix it by learning to say "no" more often. It is a missing-systems problem. By the definition the project management world actually uses, an expansion to scope is only "creep" when it happens without going through change control, which means the cure is never willpower at the moment a client asks for "one small thing." The cure is having three things in place before that moment arrives: a written scope with explicit out-of-scope exclusions, one low-friction path that re-prices and re-times every addition, and a verbatim record of what was actually agreed in meetings so the "but you said yes on the call" argument never happens. That last piece is the one most teams skip, and it is the one that makes the other two enforceable.
What scope creep actually is (and the one test that defines it)
Start with the definition, because most of the bad advice comes from getting it wrong. The PMI Lexicon of Project Management Terms defines scope creep as "the uncontrolled expansion to product or project scope without adjustments to time, cost, and resources." The PMBOK Guide says nearly the same thing: adding features and functionality without addressing the effects on time, cost, and resources, or without customer approval.
Read those definitions carefully and you find the test that matters: authorization. As the widely cited Larson and Larson PMI paper puts it, "If an expansion of scope is approved, then it is not scope creep." A client changing their mind is not scope creep. A new requirement showing up in week six is not scope creep. Those are normal. They only become creep when the addition slips into the work without anyone adjusting the timeline, the budget, or the deliverable list to account for it.
This reframe changes everything about what you try to fix. If you think the goal is to stop changes, you turn into the person who fights every client request, and you lose the relationship anyway. If you understand that the goal is to control changes, you stop fighting and start pricing. Every request gets a clean answer: here is what it costs and here is the new date.
One more distinction worth getting right, because teams confuse the two and then apply the wrong fix. Scope creep and gold plating are not the same thing.
- Who initiates: usually the client, sometimes a stakeholder
- What happens: an unrequested-in-the-contract addition gets worked without a change request
- Root cause: no change-control process, or one nobody uses
- The fix: route every ask through one re-pricing path
- Who initiates: your own team
- What happens: the team adds polish or features nobody asked for
- Root cause: a team-discipline gap, not a client gap
- The fix: tie work to the agreed deliverable list, not 'what would be nice'
If your problem is your own team shipping extras to impress the client, no change-control form on earth will fix it; that is a delivery-discipline conversation. This guide is about the other one: the unmanaged, often client-initiated additions that quietly eat the budget you set aside for the work you actually agreed to do.
Why scope creep happens: five root causes, one pattern
The same Larson and Larson paper lists the top five causes of scope creep, and the pattern across all of them is the point.
- Ambiguous or unrefined scope definition. Vague phrases like "improve the experience" have no defined end. The client's imagination fills the gap, and so does your team's.
- Lack of any formal scope or requirements management. There is no baseline to compare a new request against, so nobody can tell what is "extra."
- An inconsistent process for collecting product requirements. Requirements arrive in emails, hallway chats, and call asides, and never get reconciled.
- Weak sponsor and stakeholder involvement. No one with authority is consistently saying what is in and out.
- Project length. The longer the project runs, the more chances for unmanaged change to accumulate.
Notice what is not on that list: "the team lacked backbone." Every single cause is a missing system, not a missing personality. That is the whole thesis. You do not out-discipline scope creep at the moment of the ask. You install the systems beforehand so the moment of the ask has a clear, low-drama answer.
And this is not a rare event you can pin on one difficult client. It is a structural failure rate.
The three systems that actually prevent it
If creep is a systems gap, the cure is three artifacts, in place before kickoff.
System 1: a scope document that lists what is OUT
A list of deliverables is not enough protection, because ambiguity gets filled by assumptions on both sides. Larson and Larson are explicit that scope statements should include both what is in scope and what is out, and that a Work Breakdown Structure (WBS) decomposing deliverables into work packages "is a must."
Write the out-of-scope section like it is the most important part of the document, because it is the part you will point at later. Be specific and a little blunt:
IN SCOPE
- Up to 5 page templates (home, about, services, blog index, contact)
- 2 rounds of revisions per template
- Responsive layouts for desktop, tablet, mobile
- Acceptance: client sign-off in writing within 5 business days of delivery
OUT OF SCOPE (available as a separate change order)
- Additional page templates beyond the 5 listed
- Copywriting (client supplies final copy)
- Logo or brand identity work
- Third-party integrations (CRM, payment, booking)
- More than 2 revision rounds per template
- Ongoing maintenance after launch
The out-of-scope list does most of the work. When a client says "while you're at it, can you redo the logo," you do not argue. You point to the line that already says logo work is a separate change order. The document said no for you, months ago, calmly.
If you are still in the proposal stage, build these boundaries into the document itself. Our guides on how to create a proposal and creating a proposal for a project cover where the in/out language lives.
System 2: one low-friction change-control path
PMBOK calls this "Perform Integrated Change Control": the process of reviewing all change requests, approving or rejecting them, managing changes to the deliverables and the plan, and communicating the decisions. On a big program a Change Control Board owns it. On your project, "the board" might just be you and the client, and that is fine. What matters is that there is exactly one path and it gets used.
The most common failure here is making the process so heavy that people route around it. If logging a change takes ten minutes and a form with twelve fields, your own team will skip it for "small" requests, and small requests are exactly how creep enters. Keep it light enough that there is no excuse not to use it.
- 1
Request received
Any ask that touches scope, even a 'quick' one from a status call. No request is too small to enter the loop.
- 2
Logged with one owner
It goes to one named person and one place (a form, a shared doc, a ticket). Not scattered across inboxes.
- 3
Impact assessed
Estimate the effect on time, cost, and scope. What moves, what it adds, what date slips.
- 4
Approve or reject
The client chooses with full information. You are offering an option, not refusing a favor.
- 5
Written confirmation
The decision goes back in writing, sourced from the actual conversation, so there is one shared record.
The reframe that makes this survivable: you never answer a change request with yes or no. You answer with impact. "Happy to add that. It is roughly 12 hours, which is $1,800, and it pushes launch to the 24th. Want me to write it up?" Now the client owns the trade-off. You are not the obstacle; the budget and the calendar are, and the client can spend more of either if they choose.
System 3: a verbatim record so the process is enforceable
Here is the system almost everyone skips, and the reason their change control falls apart anyway. A change-control process is only as good as your ability to prove what was agreed. The dispute that kills margin is never "did we send a contract." It is "you said on the call you could squeeze that in." Without a record of what was actually said, that argument is unwinnable, and you either eat the work or sour the relationship fighting it.
This is not a small edge case. Larson and Larson identify unmanaged direct client-to-team contact, and acting on "small" requests outside a formal process, as primary mechanisms by which scope creeps in. The danger is not the formal email request. The signed-off email already triggers your loop. The danger is the offhand "oh, and can you also" in the middle of a status call, the one nobody writes down, that your designer just quietly starts doing.
So you need a record of those conversations as they happen, not retyped from memory three days later. A meeting transcript closes the gap. When every call produces a searchable, timestamped record, two things change. First, when a new ask surfaces mid-call, you (or your tooling) catch it and route it through the loop instead of letting it slip into the work. Second, when a dispute comes up later, there is no he-said-she-said; there is a record both sides can read.
A project management tool only tracks tasks that already made it into the plan. It does nothing about the verbal request in a status call that never got logged. The capture layer (a record of what was said in the meeting) is the missing upstream piece. Without it, your change-control process only governs the requests that arrived politely in writing.
Step by step: install change control without becoming the "no" person
Put the three systems together into a routine you can run on every project.
-
Write scope with in/out columns and acceptance criteria before kickoff. Make the out-of-scope list specific. Add acceptance criteria so "done" is defined, not argued. Use the kick-off meeting agenda to walk both lists with the client out loud, so the boundaries are mutual, not buried in a PDF.
-
Route all change requests, including small ones, through one owner. Decide who owns the loop and where requests land. Tell the client in the kickoff: "Anything that changes what we agreed, even a small thing, send it here and I will come back with timing and cost within a day."
-
Respond with impact, never with a yes or no. Re-price and re-time every addition. The answer is always an option the client can take or leave, with the trade-off made visible.
-
Confirm decisions in writing immediately, sourced from the record. After every call where scope was discussed, send a recap that lists any new asks and how each was handled. Pull it from the meeting record, not your memory. Our guide on after-meeting emails to clients has templates for exactly this.
Here is a recap-and-impact reply you can adapt. Notice it does not refuse anything:
Subject: Recap + change request from today's call
Hi [Name],
Good call today. Quick recap of decisions:
- Approved the homepage layout (v2) as final.
- You asked to add a fifth service page and a booking integration.
Both of those sit outside the original 5-page scope, so I have written
them up as a change order:
- Fifth service page: ~8 hrs / $1,200
- Booking integration: ~16 hrs / $2,400
- New launch date if both are approved: [date]
Reply "approved" and I will start. Happy to do one and not the other,
or to swap something out of the current scope to keep the date. Your call.
Thanks,
[You]
That email is the whole playbook in one message: it recaps from the record, names the out-of-scope items against the written boundary, prices the change, re-times it, and hands the decision to the client. Nobody is the bad guy.
Close the verbal-agreement gap (the move that matters most)
If you only change one thing, make it this: stop relying on memory to enforce scope. The reason change control breaks is almost always that the request entered through a conversation nobody captured, and by the time it surfaces as a dispute, both sides remember a different version of a real call.

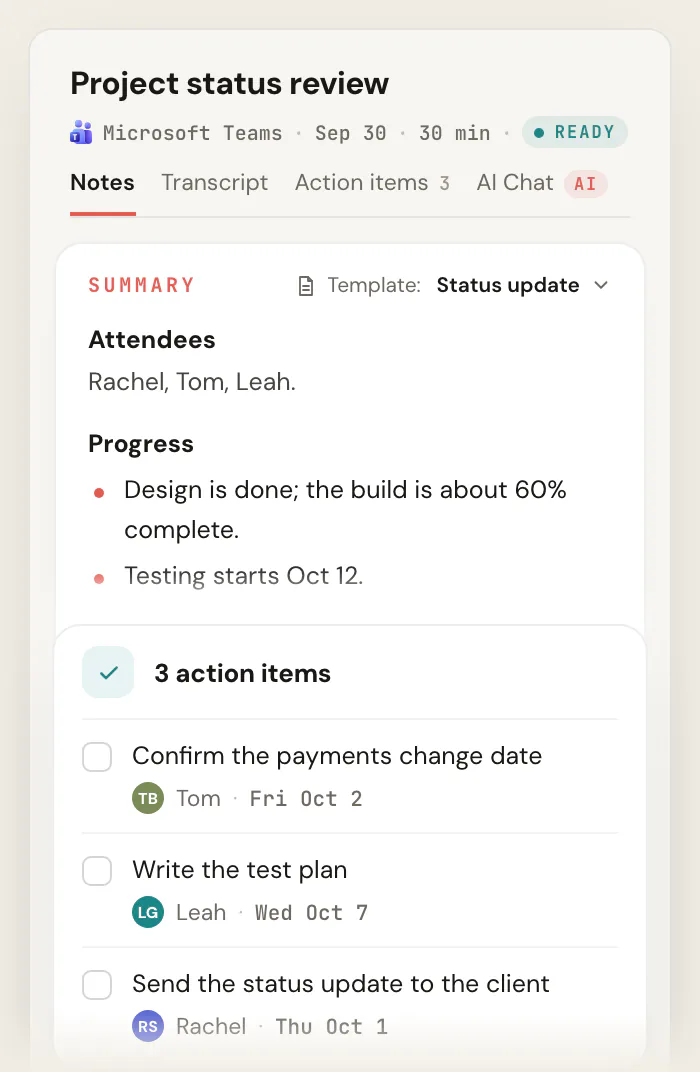

An AI notetaker closes that gap by turning every meeting into a record you can search and quote. Scribbl records, transcribes, and summarizes your Google Meet calls from the browser, with no bot joining the meeting, then pulls out action items automatically. That transcript is the verbatim record that makes change control stick. When a client later says "you agreed to that on the call," you can open the actual call and read back what was said. On the Team plan it does the same for Zoom and Microsoft Teams, which matters if your delivery and client calls live on different platforms.
The practical loop is short: meeting happens, transcript and summary generate automatically, you scan the auto-extracted action items for any new asks (a request for a fifth service page, a booking integration), route them through change control, and send the written confirmation. The record is the upstream catch that prevents the "small" request from ever becoming silent work. If you want the deeper habit around the capture itself, see how to take better meeting notes and action item tracking.
For teams whose whole business is client delivery, this is worth wiring into the standard process. That is the angle in Scribbl for project managers, Scribbl for teams, and the agencies page, and you can see plans on the pricing page (the free Lite plan includes 10 meetings a month with no length limit, which is enough to try the habit before you commit).
Handling the common scenarios without torching the relationship
The "just one small thing" drip. This is the most dangerous one because each ask is genuinely small, and saying no to a small thing feels petty. Do not say no. Acknowledge it, log it, send the impact, and let the client choose. Ten small things priced honestly is a change order. Ten small things absorbed silently is a blown margin and a resentful team.
The mid-project pivot. Sometimes a real new requirement appears, and the client is not being unreasonable; the project genuinely needs it. Scrum has a clean rule for this: if something comes in, something must come out. The 2020 Scrum Guide says scope "may be clarified and renegotiated with the Product Owner as more is learned." So renegotiate. Add the new thing and move the date, or swap it for something of equal size already in scope. Just do not silently absorb it.
The sales-versus-delivery mismatch. The classic agency wound: the salesperson promised something on the pitch call that delivery never heard about. The recorded sales or kickoff call is your source of truth for what was actually promised, which is one more reason to capture those calls. If it was promised, honor it and fix your handoff. If it was not, you have the record to show that too. Our notes on managing client expectations go deeper on the handoff.
When you under-scoped. Sometimes the client is right and you simply missed something in the original scope. A clean change order still beats grudging free work, because free work trains the client to expect more of it and it sours the team. Own the miss, write the change order, and protect the next phase. That is also better client management than martyrdom; see client communication best practices.
A "good change" is the goal, not zero change
The mature operation is not change-proof. It is change-priced. The Agile Manifesto's second principle says to "welcome changing requirements, even late in development," and to treat that change as a competitive advantage for the customer. Scrum renegotiates scope with the Product Owner continuously. The whole point is that change is normal, expected, and fine, as long as it is controlled.
So do not aim for a project where nothing changes. Aim for one where every change is logged, re-priced, re-timed, and confirmed in writing against a record of what was actually said. That is the difference between scope creep and a healthy, well-managed project. Build the three systems before kickoff, and the moment a client asks for "one small thing," you will not need willpower. You will already have the answer.
Frequently asked questions
Is a client changing their mind the same as scope creep?
No, and this is the most common misunderstanding. Per the PMI Lexicon and PMBOK, an expansion is only scope creep when it happens without adjusting time, cost, and resources. As the Larson and Larson paper puts it, "if an expansion of scope is approved, then it is not scope creep." A client changing their mind is normal. It becomes creep only if you absorb the change without logging, pricing, and re-timing it.
How do I prevent scope creep without damaging the client relationship?
Stop answering change requests with yes or no, and start answering with impact. Every ask gets the same response: here is what it adds in time and cost, do you want it? That makes you a partner offering options rather than a gatekeeper refusing favors. The relationship survives because the client, not you, owns the trade-off between budget, timeline, and the new request.
What is the difference between scope creep and gold plating?
The initiator. Scope creep is usually client-driven additions worked without a change request. Gold plating is your own team adding unrequested polish or features. Both hurt margin, but the fix differs: creep is a change-control problem, and gold plating is a team-discipline problem. Diagnose which one you actually have before you try to fix it.
Doesn't Agile mean there's no scope and clients can change anything?
No. Agile welcomes changing requirements, but through explicit negotiation, not unbounded change. The 2020 Scrum Guide says scope is "clarified and renegotiated with the Product Owner" and that developers negotiate the Sprint Backlog "without affecting the Sprint Goal." The rule of thumb is: if something comes in, something comes out. Agile is controlled change, not no scope.
Will a project management tool stop scope creep on its own?
Not by itself. A project management tool tracks work that already made it into the plan. It does nothing about the verbal "oh, and can you also" in a status call that never got logged, which is exactly where most creep enters. You need the capture layer too: a record of what was said in the meeting, so new asks get caught and routed through change control instead of silently becoming work.
Try Scribbl
Let your meetings take their own notes.
Scribbl records, transcribes, and summarizes your Google Meet calls from your browser. No bot joins the call. Free forever for individuals.
Add to Chrome · It's free
