Project Management
Project management 11 min read

How to manage multiple projects without dropping any of them

A repeatable system for managing multiple projects at once: limit work in progress, prioritize by value, and kill the context-switching tax. Tools come last.

Updated June 12, 2026

If you are drowning in five projects at once, the fix almost certainly is not another app. The two things actually breaking are parallelism (you have too much work in progress) and the hidden tax you pay every time you switch from one project to another. The genuinely best approach is the opposite of what overload pushes you toward: deliberately run fewer projects at once, put everything in one source of truth, rank work by strategic value instead of who is shouting loudest, and capture project context automatically so re-entering each project is instant instead of archaeological.

Tools serve that system. They do not replace it. This guide gives you the order of operations almost everyone skips: fix the system first, then pick the tool that fits it.

9.9%
of every dollar wasted on poor project performance (PMI, 2018)
40%
of productive time can be lost to task switching (APA)
48%
of projects are not completed on time (PMI, 2018)
What's at stake Sources: PMI 2018 Pulse of the Profession (surveyed Oct 2017, n=5,702); American Psychological Association, 'Multitasking: Switching costs.' As of June 2026.

Why managing multiple projects actually breaks

The default story you tell yourself is "I just need to be more disciplined" or "I need a better tool." Both miss the real culprits.

The first is parallelism. There is a piece of math behind this called Little's Law: average cycle time equals average work in progress divided by average throughput. In plain English, if your team finishes the same amount of work per week, then doubling the number of projects in flight roughly doubles how long each one takes to finish. Running everything at once does not get you done faster. It gets everything done later, all at the same time, at the end. (Source: businessmap.io on Little's Law, as of June 2026.)

The second is the switch cost. The American Psychological Association, citing research by psychologist David Meyer, reports that the brief mental blocks created by shifting between tasks can cost as much as 40 percent of someone's productive time. The cost gets worse when the things you switch between are dissimilar, which is exactly what jumping between unrelated projects is. (Source: APA, "Multitasking", as of June 2026.)

So "managing multiple projects" is not really a skill of holding more in your head. It is a skill of putting fewer things in flight and making each switch cheaper.

Project vs. program vs. portfolio: name what you are doing

Before you build a system, classify your situation, because the right approach is different for each.

The Project Management Institute defines a program as "a group of related projects managed in a coordinated manner to obtain benefits and control not available from managing them individually." That last clause is the whole point. If your projects share an outcome, you should manage them as one program with a shared roadmap and shared risk list, not as N silos that happen to have the same owner. A portfolio is the full set of work your team chooses to invest in, related or not. (Source: PMI, "Understanding the difference between programs and projects", as of June 2026.)

A program
  • What it is: related projects coordinated for one shared outcome
  • Example: three projects that all feed a single product launch
  • Manage it as: one roadmap, one risk list, shared dependencies
A portfolio
  • What it is: the full set of work you choose to invest in
  • Example: a marketing agency running five unrelated client accounts
  • Manage it as: prioritize across the set, cap how many run at once
Classify your situation Grounded in PMI definitions. As of June 2026.

Quick self-test: if finishing project A changes what project B needs, you are running a program, so coordinate them. If the projects are independent and just compete for the same people and hours, you are running a portfolio, so the lever is prioritization and work-in-progress limits. Most overloaded individuals and agency leads are running a portfolio and treating it like a pile.

The five-step system

Here is the spine of the method. The steps are in order on purpose: each one makes the next one work.

  1. 1

    Build one source of truth

    Every project's status, owner, deadline, and decisions live in one place, not scattered per project.

  2. 2

    Limit work in progress

    Cap how many projects are active at once. Park the rest in a clearly labeled backlog.

  3. 3

    Prioritize by value, not by volume

    Rank work by strategic value vs. effort, not by who emailed you most recently.

  4. 4

    Kill the context-switching tax

    Batch similar work, time-block per project, and capture meeting context so re-entry is instant.

  5. 5

    Run a predictable rhythm

    One weekly portfolio review plus lightweight async status beats endless ad-hoc check-ins.

The system Do them in order. Tool selection comes after step 1, not before it.

Step 1: Build one source of truth

The single highest-impact move is making every project visible in one place. Status, owner, next milestone, and key decisions should all live in one board or sheet, not in seven different threads, docs, and someone's head.

Two rules make this stick. First, standardize intake: every new project enters the system the same way, with the same fields, so nothing arrives "informally" and stays invisible. Second, one accountable owner per project. Shared ownership means no ownership.

Notice that tool selection has not happened yet. Pick the tracker after you know your workflow, not before. If you want help choosing, compare options in our best project management tools roundup and the project management tools comparison. The tool that fits your already-defined system is the right one, even if it is a boring spreadsheet.

Step 2: Limit work in progress

This is the lever that feels wrong and works anyway. Set an explicit cap on how many projects a person or team runs at once. Three active projects per owner is a reasonable starting cap for most knowledge teams; tune it to your reality. Everything over the cap goes into a "Next" lane, and you do not start it until something in "Active" ships.

Why it works: Little's Law again. Cutting work in progress shortens the cycle time of every active project, so things actually reach "Done," and the list shrinks instead of growing. A project that is 90 percent done is worth nothing until it is shipped. Finishing beats starting.

The promotion rule is simple: nothing moves from "Next" to "Active" until an "Active" slot opens. Write that rule down where the board lives so nobody quietly violates it during a busy week.

Step 3: Prioritize by value, not by who is shouting

The famous urgent-versus-important idea traces to a line Dwight Eisenhower delivered on August 19, 1954, attributing it to an unnamed former college president: "I have two kinds of problems, the urgent and the important. The urgent are not important, and the important are never urgent." (Source: Quote Investigator, as of June 2026.) Worth noting: Eisenhower did not draw the four-quadrant "matrix" people attribute to him. That came later, popularized by Stephen Covey.

The practical takeaway across a portfolio is that the loudest request is rarely the most valuable project. Score each project on two axes instead of vibes:

Priority score = strategic value (1-5)  /  effort to ship (1-5)

Example:
  Acme rebrand        value 5 / effort 3  = 1.67   -> run now
  Internal wiki move  value 2 / effort 4  = 0.50   -> park
  Q3 product launch   value 5 / effort 2  = 2.50   -> run now

Run the highest scores within your work-in-progress cap. The important-but-not-urgent work (the kind that compounds, like a launch or a process fix) is exactly what gets crowded out by urgent noise, so protect it on purpose.

Step 4: Kill the context-switching tax

You cannot eliminate switching across multiple projects, but you can make each switch cheaper. Two moves do most of the work.

Batch and time-block. Group similar work (all your client calls Tuesday morning, all writing Wednesday afternoon) so you switch contexts a few times a day instead of a few times an hour. Switching between dissimilar projects is the most expensive kind, per the APA research above, so cluster the similar stuff.

Then attack the biggest hidden cost, which is re-entry. Every time you come back to a project after days away, you spend real time reconstructing where things stood: what was decided, what you owe, what is blocked. If that context lives only in your memory and scattered threads, re-entry is archaeology.

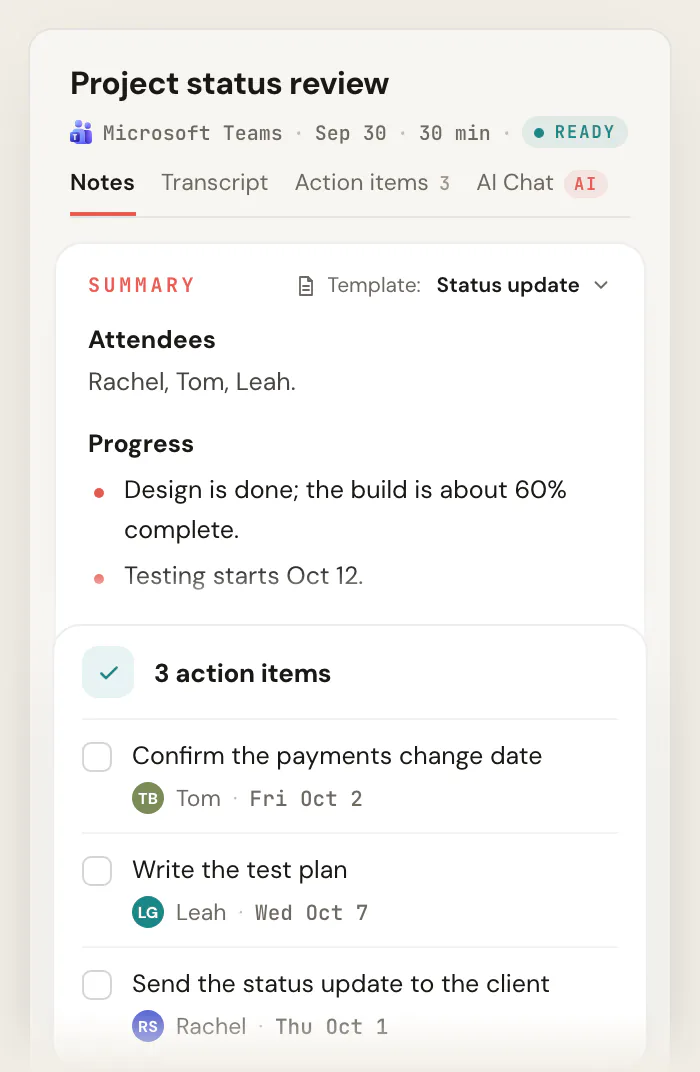

The fix is to capture decisions and action items the moment they happen, which for most teams means in meetings. If every project's last conversation is automatically transcribed, summarized, and searchable, then re-entry becomes a 30-second read instead of a 30-minute dig. This is the one place a tool earns its keep on this specific problem. Scribbl records, transcribes, and summarizes your Google Meet calls and pulls out action items, with no bot joining the meeting, so each project's history is captured without anyone playing scribe. (Pro covers unlimited Google Meet for individuals; Team adds Zoom and Microsoft Teams. See pricing.) Project managers can see how it fits their workflow on the Scribbl for project managers page, and there is more on the discipline of routing what you capture in our guide to action item tracking.

Step 5: Run a predictable rhythm

Ad-hoc check-ins are how status work expands to fill all your time. Replace them with a fixed cadence: one short weekly portfolio review where you look at every active project's status, blockers, and the "Next" lane, plus lightweight async status updates the rest of the week.

The trick that cuts your meeting load is transparency. If the board shows status, overdue items, and blockers automatically, you stop holding meetings whose only purpose is to ask "where are we." For the format of those updates, our project status report example gives you something copy-pasteable, and how to measure team productivity covers the signals worth tracking instead of activity theater.

A one-week setup plan

You do not need a two-month rollout. Here is a five-day version.

Day 1  Inventory. List every active project, owner, and real deadline.
       Be honest about how many are truly "in progress."
Day 2  Consolidate into one board: Active / Next / Parked columns.
       Add fields: owner, next milestone, status, last decision.
Day 3  Set a WIP cap (start at 3 active per owner). Move overflow
       to "Next." Write the promotion rule on the board.
Day 4  Score every project (value / effort). Reorder "Next" by score.
       Block calendar time for the top important-not-urgent project.
Day 5  Set the cadence: a 30-min weekly portfolio review + async
       status. Turn on automatic meeting capture so re-entry is free.

What "good" looks like after 30 days: fewer projects in flight at once, more projects actually crossing the finish line, a board anyone can read in 60 seconds, and far fewer "quick sync" meetings because the status is already visible. If you lead an agency juggling client work, the same system applies, and the client-facing angle is covered in agency project management and how to manage client expectations.

Frequently asked questions

How many projects can one person realistically manage at once?

For deep, active project work, most people manage two or three well and degrade fast past that, mainly because of the switch costs the APA describes (up to 40 percent of productive time lost). You can oversee more if they are mostly parked and waiting, but "overseeing" and "actively driving" are different jobs. Start with a cap of three active per owner and adjust based on whether things actually finish.

Is this program management, or just managing multiple projects?

It depends on whether your projects share an outcome. PMI's definition is the test: if the projects are related and coordinated to get a benefit you could not get by running them separately, that is a program, and you should manage shared roadmaps, dependencies, and risks across them. If they are independent and only compete for your time, you are managing a portfolio, and the levers are prioritization and work-in-progress limits.

What tool should I use to manage multiple projects?

Whichever one fits the system you built in steps 1 through 5, which is why you pick it last. If your workflow is simple, a shared spreadsheet with Active/Next/Parked columns is genuinely enough. If you need dependencies, automations, and multiple views, a dedicated tool earns its cost. Compare specifics in best project management tools. The mistake is buying the tool first and hoping it imposes a system; it never does.

How do I keep stakeholders updated without endless status meetings?

Make status visible by default and async. A shared board that shows each project's status, owner, blockers, and overdue items removes the need for meetings whose only purpose is to gather updates. Send a short weekly written recap (see our project status report example), and keep one live review for decisions and blockers, not status reading. Automatic meeting notes help here too, because the record of what was decided already exists without anyone writing a recap from memory.

Does running fewer projects at once really make me faster?

Yes, and Little's Law is why. Holding your team's throughput constant, the more items you work on in parallel, the longer each one takes to finish. Fewer projects in flight means shorter cycle times and more completions, which shrinks your list. It feels like doing less. It results in finishing more.
