Project kickoff meeting agenda: 7 questions, 3 templates

A project kickoff meeting agenda built on seven questions, with copy-paste templates for internal, standard, and complex projects, plus how to capture it.

Updated June 12, 2026

A project kickoff meeting agenda should answer seven questions in order: why this project, who owns what, when it ships, how much it costs, what could go wrong, how the team will communicate, and what success looks like. If your agenda answers all seven on paper before any work starts, the project has a spine. If it skips one (usually scope boundary or success criteria), that is the gap the project falls through later. This post gives you the seven-question framework, three copy-paste templates sized to the project, and the part most teams botch: turning the meeting into a record that survives the week.

The agenda is not the goal. The goal is a set of written, agreed decisions. The agenda is just the fastest path there. So we will lead with the templates you came for, then explain why each question earns its place.

The seven questions every kickoff has to answer

Strip away the formatting and every good kickoff agenda is the same seven questions. Skip one and you create a known failure mode.

#QuestionWhat it must produce
1Why this project, why now?One agreed sentence on the business outcome
2Who owns what?One accountable owner per workstream (RACI)
3When does it ship?Agreed milestones and critical-path dependencies
4How much will it cost?Budget boundary and resourcing assumptions
5What could go wrong?Top three risks, each with an owner
6How will we communicate?Cadence, channels, and the single source of truth
7What does success look like?Measurable success criteria everyone signs off on

That order is deliberate. Purpose frames everything. Ownership and timeline come next because they are the decisions people argue about. Budget and risk are guardrails. Communication and success criteria are what make the alignment last past the call. Run the questions top to bottom and the agenda runs the meeting for you.

  1. 1

    1. Why? (purpose)

    One sentence on the business outcome. If you cannot write it, the project is not ready.

  2. 2

    2. Who? (roles)

    Exactly one Accountable owner per workstream, mapped on a RACI.

  3. 3

    3. When? (timeline)

    Milestone dates and the dependencies on the critical path.

  4. 4

    4. How much? (budget)

    The budget boundary and the resourcing it assumes.

  5. 5

    5. What if? (risk)

    The top three risks, each with a named owner.

  6. 6

    6. How do we talk? (comms)

    Status cadence, channels, and where work lives.

  7. 7

    7. What is success? (criteria)

    Measurable definition of done, agreed by everyone.

The seven questions, in order Each question owes one written decision. The decision is the deliverable, not the discussion.

Template 1: standard 60-minute kickoff (copy, paste, send)

This is the default. Paste it into a Google Calendar invite or a shared doc, replace the bracketed placeholders, and send it 48 hours ahead with the pre-read. Each block has a time box and one decision it must produce.

PROJECT KICKOFF: [Project name]
Date / time: [date], [start]-[end] (60 min)
Attendees: [sponsor], [PM], [delivery leads], [client owner]
Pre-read (sent 48h ahead): project brief / charter v0.1, draft RACI

00:00  Welcome + why this, why now (8 min)
       -> One agreed sentence on the business outcome.

00:08  Scope: in / out + change process (12 min)
       -> Written in-scope list, out-of-scope list, change-request path.

00:20  Plan + milestones (10 min)
       -> Agreed milestone dates and critical-path dependencies.

00:30  Roles + RACI (10 min)
       -> Exactly one Accountable owner per workstream.

00:40  Budget + resourcing (5 min)
       -> Budget boundary and the resourcing it assumes.

00:45  Risks + dependencies (5 min)
       -> Top 3 risks named with an owner each.

00:50  Communication + tools (5 min)
       -> Status cadence, channels, single source of truth.

00:55  Success criteria + next steps (5 min)
       -> Measurable definition of done; read action items aloud.

The timing is a knob, not a rule. Asana's official kickoff guide recommends 30 to 45 minutes for a simple internal project and 60 to 90 minutes for a complex initiative with multiple stakeholders, and it puts a productive kickoff at 5 to 10 attendees rather than a crowd (Asana, "Run a successful project kickoff meeting," accessed 2026-06-13). Start at 60 and stretch the Scope and Plan blocks for bigger engagements. For a deeper breakdown of the timed-script version of this meeting, see our companion guide, the agenda for a project kick-off meeting.

Template 2: lean 30-minute internal kickoff

For a small internal project with a team that already knows each other, you do not need the polish. Cut the intros, keep the decisions. This is the version Asana sizes at 30 to 45 minutes for simple work.

INTERNAL KICKOFF: [Project name]  |  30 min
Attendees: [PM] + [delivery team]
Pre-read: one-page brief + draft RACI

00:00  Purpose + success criteria (6 min)
       -> Outcome sentence + measurable definition of done.

00:06  Scope: in / out + change process (8 min)
       -> Both lists written live.

00:14  Roles + RACI (7 min)
       -> One Accountable owner per workstream.

00:21  Plan + top risks (6 min)
       -> Milestones + the three risks that scare you most.

00:27  Action items + owners + due dates (3 min)
       -> Read them back out loud before anyone leaves.

Template 3: 90-minute client or complex kickoff

For a multi-stakeholder or external engagement, this is the most polished version and it earns the extra time. Asana frames external kickoffs as needing greater polish, formal presentation, and clear communication protocols, because they represent your organization to the client (Asana, accessed 2026-06-13). The added blocks are budget, the cross-org escalation path, and a longer Q&A.

CLIENT KICKOFF: [Client] x [Your team]  |  90 min
Attendees: [client sponsor], [client owner/approver], [your PM],
           [your delivery leads]
Pre-read (48h ahead): project charter v0.1, draft RACI, draft timeline

00:00  Welcome + intros + why this, why now (10 min)
00:10  Scope: in / out + change-request process (15 min)
00:25  Plan + milestones + dependencies (15 min)
00:40  Roles + RACI + client-side approval owner (15 min)
00:55  Budget boundary + resourcing assumptions (10 min)
01:05  Risks + dependencies + escalation path (10 min)
01:15  Communication plan + tools + status cadence (5 min)
01:20  Success criteria (measurable) + open Q&A (5 min)
01:25  Next steps + action items, read aloud (5 min)
Internal kickoff
  • Length: 30 to 45 minutes.
  • Goal: align the delivery team on objectives, roles, and cadence.
  • Polish: low. Whiteboard and argue freely.
  • Heaviest blocks: Roles/RACI and Plan.
  • Run it first to pressure-test the plan before any client sees it.
Client / complex kickoff
  • Length: 60 to 90 minutes.
  • Goal: set expectations, establish business value, build trust.
  • Polish: high. This is the version the client sees.
  • Heaviest blocks: Scope boundary, Budget, Comms.
  • Add: client-side approval owner and the cross-org escalation path.
Pick the size that fits the project Durations follow Asana's official guidance (accessed 2026-06-13); the structure is the same seven questions either way.

If you run client work, the agency add-ons matter most. Name the client-side approval owner (who signs off on deliverables), write the budget and scope boundary down explicitly, and agree the escalation path between the two organizations before anyone needs it. Our guides on managing client expectations and the agency workflow go deeper on the relationship side.

What a kickoff is actually for (and why most fail)

A kickoff is not a status update and it is not a pitch. Its job is to convert ambiguity into written, agreed decisions before the team commits real hours. The test of a good one is blunt: when it ends, is there a finished artifact everyone signed off on, or just a warm feeling that "we are aligned"?

The most common failure is the one-way presentation. You build slides, walk the client through them, get nods, and leave with agreement-in-the-room and nothing on paper. Two weeks later the scope is contested and nobody can point to where it was settled. The fix is to anchor the whole meeting to one document. In PMBOK terms that is the project charter: the document the sponsor issues to authorize the project and give the manager authority to apply resources. Its standard contents are the purpose, measurable objectives and success criteria, scope boundaries and deliverables, assumptions and constraints, a summary milestone schedule, the key stakeholder list, approval and exit criteria, and the sponsor's sign-off. Your seven questions map one-to-one onto those sections.

One more non-negotiable: send the agenda and the pre-read at least 48 hours ahead. If people walk in cold, you spend the hour delivering context a one-page brief could have carried, and you run out of time before the questions that prevent failure. The pre-read is what lets the hour be about resolving, not informing. See our meeting preparation checklist for the full pre-send routine.

The three answers that actually prevent project failure

All seven questions matter, but three of them are the difference between a project that drifts and one that ships. Get these right even if you rush the rest.

Who owns what, via RACI (not a name list). Listing "who is on the team" is not the same as assigning accountability. A RACI matrix gives every task four roles: Responsible (does the work), Accountable (the single owner who answers for completion), Consulted (gives input before the work is done), and Informed (kept up to date). The hard rule is that every workstream has exactly one Accountable owner (Atlassian, "RACI chart," accessed 2026-06-13).

The scope boundary, written live. During the Scope block, do not describe the work in prose. Open two lists, "In scope" and "Out of scope," and fill them on the screen while everyone watches. Then write the change-request process: who can request a change, who approves it, and what it does to the timeline and budget. The out-of-scope list is the one people skip and the one that saves you. For the full defense, see how to prevent scope creep.

Success criteria, measurable. Before the meeting ends, write the definition of done that everyone can agree to. They must be measurable, not aspirational. "Launch the new site" is not a success criterion. "New site live on [date], passing [load-time target], with [conversion baseline] measured for two weeks" is. If you cannot measure it, you cannot agree on whether the project worked.

30-90 min
Asana: 30-45 min simple internal, 60-90 min complex
5-10
Asana: a productive kickoff has 5-10 attendees
1
RACI: exactly one Accountable owner per workstream (Atlassian)
What the playbook says Asana official kickoff guidance and Atlassian RACI guidance (accessed 2026-06-13).

Map the seven questions to the charter

Here is the trick that makes a kickoff feel inevitable instead of improvised: each question fills one section of the charter. Run the meeting and the charter fills itself in.

Agenda questionCharter section it completes
Why? (purpose)Project purpose + measurable objectives
Scope: in / out + change processScope boundaries, deliverables, change control
When? (plan)Summary milestone schedule
Who? (RACI)Project team + key stakeholder list
How much? (budget)Resourcing assumptions and constraints
What if? (risk)Overall risk, assumptions, constraints
What is success?Approval and exit criteria
Next stepsSponsor sign-off to proceed

When the last cell is filled, you are done. If a cell is still blank, that is your remaining open question, and it gets an owner and a date in the Next steps block. For the artifact itself, our project summary template gives you a fill-in-the-blank starting point.

Capture the alignment so it survives the meeting

You fought for written scope, a clean RACI, and measurable success criteria. All of it evaporates if the only record is a few hurried notes. The durable output of a kickoff is three things: a transcript, a decisions log, and action items with owners and due dates, distributed the same day before anyone's memory fades. Our meeting action items template keeps that last part consistent across every project.

If your team is on a paid Google Workspace plan, native Meet recording can help, but know the limits. Recording is gated to specific editions (Business Standard, Business Plus, the Enterprise tiers, Education Plus, Workspace Individual, and Google One subscribers with 2 TB or more), it saves to the organizer's Meet Recordings folder in Drive, and free or personal Google accounts cannot record at all (Google Meet Help, "Record a video meeting," accessed 2026-06-13). A raw recording is also not a decisions log. Someone still has to watch it back and type those up.

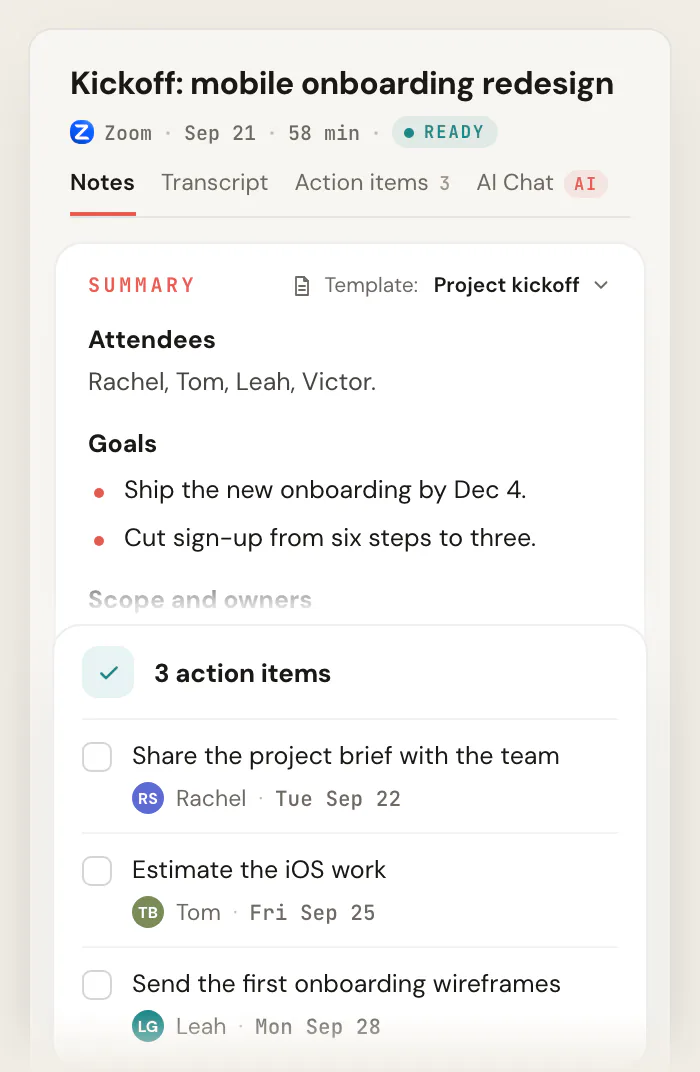

This is the one place Scribbl is honestly the right tool. It is an AI notetaker for Google Meet that records, transcribes, and auto-extracts action items from your kickoff with no bot sitting in the meeting, then produces a shareable recap. It runs from the browser, it is free for individuals, Pro adds unlimited recording, and Team adds Zoom and Microsoft Teams. For project managers specifically, the PM workflow is the same loop every time.

Scribbl recap

Kickoff recap

  • Decision: scope boundary ratified agreed
  • Decision: milestone dates set agreed
  • Action: send signed charter PM · Fri
  • Action: confirm staging access Client · Mon
  • Action: book sprint-1 review Lead · Tue
Illustration What a post-kickoff recap captures: decisions, then action items with owners and due dates. A diagram, not a screenshot.

The full loop is short: send the agenda and pre-read 48 hours ahead, run the timed kickoff, capture decisions and action items as they are agreed, then distribute the recap and assign owners before everyone leaves the call. If you would rather do it by hand, our guide on how to take better meeting notes covers the manual approach.

Frequently asked questions

How long should a project kickoff meeting be?

Start at 60 minutes. Asana recommends 30 to 45 minutes for a simple internal project and 60 to 90 minutes for a complex initiative with multiple stakeholders (accessed 2026-06-13). What drives the length is the Scope and Plan blocks, so stretch those for bigger engagements and keep intros tight. Use the 30-minute template for internal work and the 90-minute template for client engagements.

Who should attend the kickoff?

Keep it to 5 to 10 people who can actually decide and do the work: the sponsor, the project manager or lead, the delivery leads for each workstream, and on a client engagement, the client owner and their approval authority (Asana, accessed 2026-06-13). A crowd of observers slows decisions. If someone only needs the outcome, send them the recap instead of a seat.

What is the single most important part of the agenda?

The Scope block: writing the in-scope and out-of-scope lists plus the change-request process live, in front of everyone. It is the best defense against scope creep, and the block people most often rush. The Roles/RACI block is a close second, because exactly one Accountable owner per workstream is what makes the scope decisions stick.

How is a kickoff agenda different from the project charter?

The agenda is the script for the meeting; the charter is the artifact the meeting produces. Each of the seven questions fills one charter section (purpose, scope, milestones, team, budget, risk, exit criteria). When the charter is fully filled in and signed off by the sponsor, the kickoff is genuinely done.

Do I need to record the kickoff?

You need a durable record, which is not the same as a video file. The minimum is a decisions log and action items with owners and due dates, shared the same day. A recording and transcript make that easier and let people who missed it catch up. Native Google Meet recording requires a paid Workspace edition and saves to the organizer's Drive (accessed 2026-06-13); a tool like Scribbl works on free Google accounts and turns the call into a recap with action items automatically.
